Overview
In the Task Grid, some fields are read-only based on factors such as task type, scheduling mode, and other predefined conditions. These read-only fields appear grayed out, indicating that they cannot be modified. Additionally, when you hover over a read-only field, a block icon appears along with a tooltip explaining why the field is read-only.
This visual and contextual feedback helps you understand field behavior within the Task Grid, ensuring clarity and ease of use.
How It Works
When you’re in checked-in mode, you might come across fields that are not editable even when double-clicking. These fields appear grayed out with a block icon, and a tooltip explains why they are read-only and non-editable. This makes it easier for you while working on tasks.
Read-Only Fields Messages

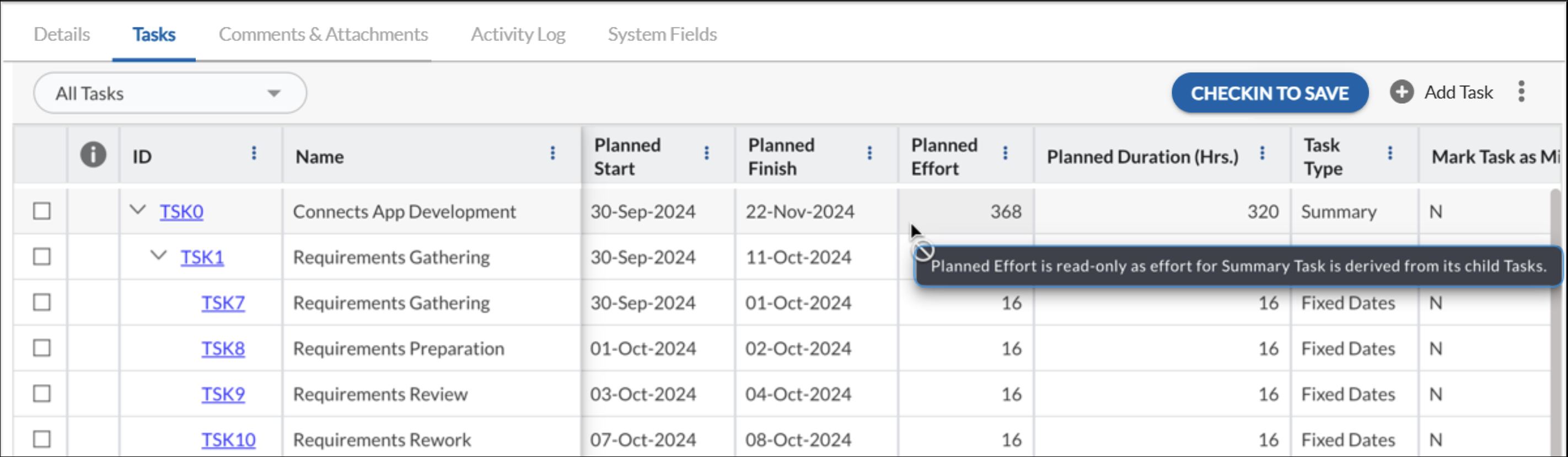

1. Scheduling Type: Simple Scheduling; Task Actuals Tracking Mode: Based on Timesheet
Column | Condition | Tooltip Message |
---|---|---|
Planned Duration (Hrs.) | Always | Planned Duration (Hrs.) is read-only as it is derived from Planned Start and Finish dates. |
Planned Start | For Summary Tasks | Planned Start is read-only as dates for Summary Task are derived from its child Tasks. |
Planned Finish | For Summary Tasks | Planned Finish is read-only as dates for Summary Task are derived from its child Tasks. |
Predecessor | For Summary Tasks | Predecessor is read-only as Summary Task cannot have dependencies. |
Resources | For Summary Tasks | Resources is read-only as Summary Task cannot have resource assignments. |
Planned Hours | Always | Normal Task: Planned Hours is read-only as it is based on resource assignment from the Planned Start to the Finish dates. Summary Task: Planned Hours is read-only as Hours for Summary Task is derived from its child Tasks. |
% Work Complete | Always | Percent Work Complete is read-only as it is percentage of Actual Hours compared to Planned Hours. |
Actual Finish | Always | Actual Finish is read-only as it is based on the last date on which logged hours is approved. |
Actual Hours | Always | Actual Hours is read-only as it is based on the logged hours approved in the Timesheet. |
Actual Start | Always | Actual Start is read-only as it is based on the first date on which logged hours is approved. |
Baseline Finish | Always | Baseline Finish is read-only as it is based on Current Baseline. |
Baseline Hours | Always | Baseline Hours is read-only as it is based on Current Baseline. |
Baseline Start | Always | Baseline Start is read-only as it is based on Current Baseline. |
Due Date | For Summary Tasks | Due Date is read-only as it is updated based on the last child task’s Planned Finish date. |
Overall Status | Always | Overall Status is read-only as it is updated based on % Work Complete. |
Owner | Always | Owner is read-only as it is updated based on the resource assignments. |
Phase | Always | Phase is read-only as it is based on the Practice chosen for generating the Tasks. |
Practice | Always | Practice is read-only as it is based on the Practice chosen for generating the Tasks. |
Remaining Hours | Always | Remaining Hours is read-only as it is the difference between the Planned and Actual Hours. |
Overall Status is Closed (Entire row) | Action cannot be performed on closed Task. | |
Overall Status is Blocked (Entire Row) | Action cannot be performed on blocked Task. |
2. Scheduling Type: Simple Scheduling; Task Actuals Tracking Mode: Manual
Column | Condition | Tooltip Message |
---|---|---|
Planned Duration (Hrs.) | Always | Planned Duration (Hrs.) is read-only as it is derived from Planned Start and Finish dates. |
Planned Start | For Summary Tasks | Planned Start is read-only as dates for Summary Tasks are derived from its child tasks. |
Planned Finish | For Summary Tasks | Planned Finish is read-only as dates for Summary Tasks are derived from its child tasks. |
Resources | For Summary Tasks | Resources is read-only as a Summary Task cannot have resource assignments. |
Planned Hours | Always | Planned Hours is read-only as it is based on resource assignments from the Planned Start to the Finish dates. |
% Work Complete | For Summary Tasks | Percent Work Complete is read-only as it is the percentage of Actual Hours compared to Planned Hours. |
Actual Finish | For Summary Tasks | Actual Finish is read-only as it is derived from its child tasks. |
Actual Hours | No Resource Assigned and For Summary Tasks | No Resource Assigned: Actual Hours is read-only as it requires a resource assignment. Summary Tasks: Actual Hours is read-only as it is derived from its child tasks. |
Actual Start | For Summary Tasks | Actual Start is read-only as it is derived from its child tasks. |
Baseline Finish | Always | Baseline Finish is read-only as it is based on the current baseline. |
Baseline Hours | Always | Baseline Hours is read-only as it is based on the current baseline. |
Baseline Start | Always | Baseline Start is read-only as it is based on the current baseline. |
Due Date | For Summary Tasks | Due Date is read-only as it is updated based on the latest child task’s Planned Finish date. |
Overall Status | Always | Overall Status is read-only as it is updated based on % Work Complete. |
Owner | Always | Owner is read-only as it is updated based on resource assignments. |
Phase | Always | Phase is read-only as it is based on the practice chosen for generating the tasks. |
Practice | Always | Practice is read-only as it is based on the practice chosen for generating the tasks. |
Remaining Hours | Always | Remaining Hours is read-only as it is the difference between Planned and Actual Hours. |
Overall Status is Closed (Entire row except PCOMP and ACT_FN) | – | This task is closed and hence not available for editing. To edit its details, re-open it first by reducing the % Work Complete to less than 100%. |
Overall Status is Blocked (Entire Row) | – | Action cannot be performed on a blocked task. |
3. Scheduling Type: Advanced Scheduling; Task Actuals Tracking Mode: Based on timesheet data
Column | Condition for Read-Only |
Reason for Read-Only |
Tooltip Message |
---|---|---|---|
Planned Duration (Hrs.) |
Read-Only Dynamic |
For FixedDates task, For summary tasks, For Milestones, & For Linked Plan |
Fixed Dates: Planned Duration (Hrs.) is read-only as it is derived from Planned Start and Finish dates. Summary Task: Planned Duration (Hrs.) is read-only as the duration for a Summary Task is derived from its child Tasks. Milestone Task: Planned Duration (Hrs.) is read-only as it is derived from Planned Start and Finish dates. Linked Plan Task: Planned Duration (Hrs.) is read-only as the duration for a Linked Plan Task is derived from its linked Task Plan. |
Planned Start |
Read-Only Dynamic |
For Summary Tasks, & For Linked Plan |
Summary Task: Planned Start is read-only as dates for Summary Task are derived from its child Tasks. Linked Plan Task: Planned Start is read-only as dates for Linked Plan Task are derived from its linked Task Plan. |
Planned Finish |
Read-Only Dynamic |
For Summary Tasks, & For Linked Plan |
Summary Task: Planned Finish is read-only as dates for Summary Task are derived from its child Tasks. Linked Plan Task: Planned Finish is read-only as dates for Linked Plan Task are derived from its child Tasks. |
Planned Hours |
Read-Only Dynamic |
For Summary Tasks, For Milestone, & For Linked Plan |
Normal Task: Planned Hours is read-only as it is based on resource assignment from the Planned Start to the Finish dates. Summary Task: Planned Hours is read-only as Hours for Summary Task is derived from its child Tasks. Milestone Task: Planned Hours is read-only as Milestone Task cannot have resource assignments. Linked Plan Task: Planned Hours is read-only as Hours for Linked Plan Task is derived from its child Tasks. |
Remaining Hours |
Read-Only Always |
Always | Remaining Hours is read-only as it is percentage of Actual Hours compared to Planned Hours. |
Resources | Read-Only Dynamic |
For Summary Tasks, For Milestone, For Hybrid, & For Linked Plan |
Summary Task: Resources is read-only as Summary Task cannot have resource assignments. Milestone Task: Resources is read-only as Milestone Task have zero Hours and zero duration Tasks. Hybrid Task: Resources is read-only as Hybrid Task cannot have resource assignments. Linked Plan Task: Resources is read-only as Linked Plan Task cannot have resource assignments. |
Actual Hours |
Read-Only Always |
Always | Actual Hours is read-only as it is based on the logged hours approved in the Timesheet. |
Actual Start |
Read-Only Always |
Always | Actual Start is read-only as it is based on the first date on which logged hours is approved. |
Actual Finish |
Read-Only Always |
Always | Actual Finish is read-only as it is based on the last date on which logged hours is approved. |
Priority | Always Editable |
Not Applicable |
Not Applicable |
Predecessor | Read-Only Dynamic |
For Hybrid,& For Linked Plan |
Hybrid Task: Predecessor is read-only as Hybrid Task cannot have dependencies. Linked Plan Task: Predecessor is read-only as Linked Plan Task cannot have dependencies. |
Task Mode |
Read-Only Dynamic |
For Summary Tasks |
Task Mode is read-only as it is a Summary Task. |
Task Type |
Read-Only Dynamic |
For Summary Tasks, & For manually scheduled |
Summary Task: Task Type is read-only as it is a Summary Task. Manually Scheduled Task: Task Type is not applicable as Task Mode is manually scheduled. |
Entire Task Row |
Read-Only Dynamic |
For Closed Tasks |
Action cannot be performed on closed Task. |
Entire Task Row |
Read-Only Dynamic |
For Blocked Tasks |
Action cannot be performed on blocked Task. |
3. Task Module: STaRT Plus & Task Actuals Tracking Mode: Manual
Column | Condition for Read-Only |
Reason for Read-Only |
Tooltip Message |
---|---|---|---|
Planned Duration (Hrs.) |
Read-Only Dynamic |
For FixedDates task and not manually scheduled, For summary tasks, For Milestones, & For Linked Plan |
Fixed Dates: Planned Duration (Hrs.) is read-only as it is derived from Planned Start and Finish dates. Summary Task: Planned Duration (Hrs.) is read-only as the duration for a Summary Task is derived from its child Tasks. Milestone Task: Planned Duration (Hrs.) is read-only as it is derived from Planned Start and Finish dates. Linked Plan Task: Planned Duration (Hrs.) is read-only as the duration for a Linked Plan Task is derived from its linked Task Plan. |
Planned Start |
Read-Only Dynamic |
For Summary Tasks, & For Linked Plan |
Summary Task: Planned Start is read-only as dates for Summary Task are derived from its child Tasks. Linked Plan Task: Planned Start is read-only as dates for Linked Plan Task are derived from its linked Task Plan. |
Planned Finish |
Read-Only Dynamic |
For Summary Tasks, & For Linked Plan |
Summary Task: Planned Finish is read-only as dates for Summary Task are derived from its child Tasks. Linked Plan Task: Planned Finish is read-only as dates for Linked Plan Task are derived from its linked Task Plan. |
Planned Hours |
Read-Only Dynamic |
For Summary Tasks, For Milestone, & For Linked Plan |
Normal Task: Planned Hours is read-only as it is based on resource assignment from the Planned Start to the Finish dates. Summary Task: Planned Hours is read-only as Hours for Summary Task is derived from its child Tasks. Milestone Task: Planned Hours is read-only as Milestone Task cannot have resource assignments. Linked Plan Task: Planned Hours is read-only as Hours for Linked Plan Task is derived from its linked Task Plan. |
Remaining Hours |
Read-Only Always |
Always | Remaining Hours is read-only as it is auto calculated based on Planned and Actual Hours. |
Resources | Read-Only Dynamic |
For Summary Tasks, For Milestone, For Hybrid, & For Linked Plan |
Summary Task: Resources is read-only as Summary Task cannot have resource assignments. Milestone Task: Resources is read-only as Milestone Task have zero Hours and zero duration Tasks. Hybrid Task: Resources is read-only as Hybrid Task cannot have resource assignments. Linked Plan Task: Resources is read-only as Linked Plan Task cannot have resource assignments. |
Actual Hours |
No resource assigned |
No resource assigned |
Actual Hours is read-only as resource assignments are required for recording Actual Hours. |
Actual Start |
For Summary Tasks |
For Summary Tasks |
Actual Start is read-only as it is derived from its child Tasks. |
Actual Finish |
For Summary Tasks |
For Summary Tasks |
Actual Finish is read-only as it is derived from its child Tasks. |
Percent Work Complete |
For Summary Tasks |
For Summary Tasks |
Percent Work Complete is read-only as it is derived from its child Tasks. |
Overall Status |
Read-Only Always |
Always | Overall Status is read-only as it is updated based on % Work Complete. |
Predecessor | Read-Only Dynamic |
For Hybrid, & For Linked Plan |
Hybrid Task: Predecessor is read-only as Summary Task cannot have dependencies. Linked Task: Predecessor is read-only as Linked Task Plan cannot have dependencies. |
Actual Cost |
Read-Only Always |
Always | Actual Cost is read-only as it is calculated based on Actual Hours and resource cost per hour. |
Baseline Cost |
Read-Only Always |
Always | Baseline Cost is read-only as it is based on Current Baseline. |
Baseline Duration |
Read-Only Always |
Always | Baseline Duration is read-only as it is based on Current Baseline. |
Baseline Hours |
Read-Only Always |
Always | Baseline Hours is read-only as it is based on Current Baseline. |
Baseline Finish |
Read-Only Always |
Always | Baseline Finish is read-only as it is based on Current Baseline. |
Baseline Start |
Read-Only Always |
Always | Baseline Start is read-only as it is based on Current Baseline. |
Mark Task as Milestone |
Read-Only Dynamic |
For Hybrid, & For Linked Plan |
Hybrid Task: Mark Task as Milestone is read-only as a Hybrid Task cannot be converted into a Milestone Task. Linked Plan Task: Mark Task as Milestone is read-only as a Linked Plan Task cannot be converted into a Milestone Task. |
Planned Cost |
Read-Only Always |
Always | Planned Cost is read-only as it is calculated based on Planned Hours and resource cost per hour. |
Practice | Read-Only Always |
Always | Practice is read-only as it is based on the Practice chosen for generating the Tasks. |
Standard Code |
Read-Only Dynamic |
– | Standard code of Deliverable tasks are non-editable. |
WBS Code |
Read-Only Always |
Always | NA |
4. Default Scheduling (Live Editing)
Column | Condition | Tooltip Message |
---|---|---|
Due Date | For Summary Tasks | Due Date is read-only as due date for Summary Task is updated based on the latest child Task’s Planned Finish date. |
Planned Start | For Summary Tasks | Planned Start is read-only as dates for Summary Task are derived from its child Tasks. |
Planned Finish | For Summary Tasks | Planned Finish is read-only as dates for Summary Task are derived from its child Tasks. |
Predecessor | For Summary Tasks | Predecessor is read-only as Summary Task cannot have dependencies. |
Resources | For Summary Tasks | Resources is read-only as Summary Task cannot have resource assignments. |
% Work Complete | For Summary Tasks | Percent Work Complete is read-only as Summary Task cannot have resource assignments. |
Actual Finish | For Summary Tasks | Actual Finish is read-only as dates for Summary Task are derived from its child Tasks. |
Actual Start | For Summary Tasks | Actual Start is read-only as dates for Summary Task are derived from its child Tasks. |
Owner | Always | Owner is read-only as it is updated based on the resource assignments. |
